AysénChile

Cerro Bayo Project

Driving Innovation, Sustainability, and Growth in the Mining Industry.

Overview

Locations

Community and Heritage

Resources

Cerro Bayo hosts a Mineral Resource Estimate of 20.0Mt @ 211g/t AgEq for 136Moz AgEq, including 60Moz AgEq in the higher-confidence Indicated category, as at 30 June 2026.

The resource comprises both open pit and underground mines across 2 mining complexes with the Cerro Bayo project and is supported by the collected knowledge and drilling investment over 20yrs of mining history through the district.

Mineral Resource Estimate as at 30 June 2026

  1. Mineral Resource Estimates are classified and reported in accordance with the JORC Code.
  2. MSO shapes were generated to constrain the Resource using an NSR value of US$124/t and a minimum mining width of 1.2m.
  3. Pit optimisation shells were generated at an NSR cutoff or US$47/t to constrain the open pit resources with SMU of 3m x 5m x 5m applied.
  4. A gold price of US$3,500/oz and Silver price of US$45/oz was used to generate NSR cutoffs.
  5. Individual grades for all metals included in the metal equivalents calculation are set out in the table above. Silver equivalents are calculated using the equation AgEq = Ag(g/t) + (83 x Au(g/t)) and gold equivalents are calculated based on the equation AuEq = Au(g/t) + (Ag(g/t) / 83) based on a gold price of US$3,000/oz and Silver price of US$36/oz. Metallurgical recoveries for gold and silver are closely linked and are typically 85-93% for gold and silver. The actual assumed metallurgical recovery rate used to calculate the metal equivalents is 90% for each of gold and silver. The Company considers the estimation of metallurgical recoveries in respect of exploration work to be reasonable based on the past processing records from the nearby Cerro Bayo plant between 1995 and 2016, and work undertaken in preparing the Mineral Resource Estimate. It is the Company’s view that all elements in the silver and gold equivalents calculations have a reasonable potential to be recovered and sold.
  6. Bulk Density of 2.63g/cm3 has been applied to veins and 2.57g/cm3 has been applied to stockwork and waste domains.
  7. Numbers may not add due to rounding.

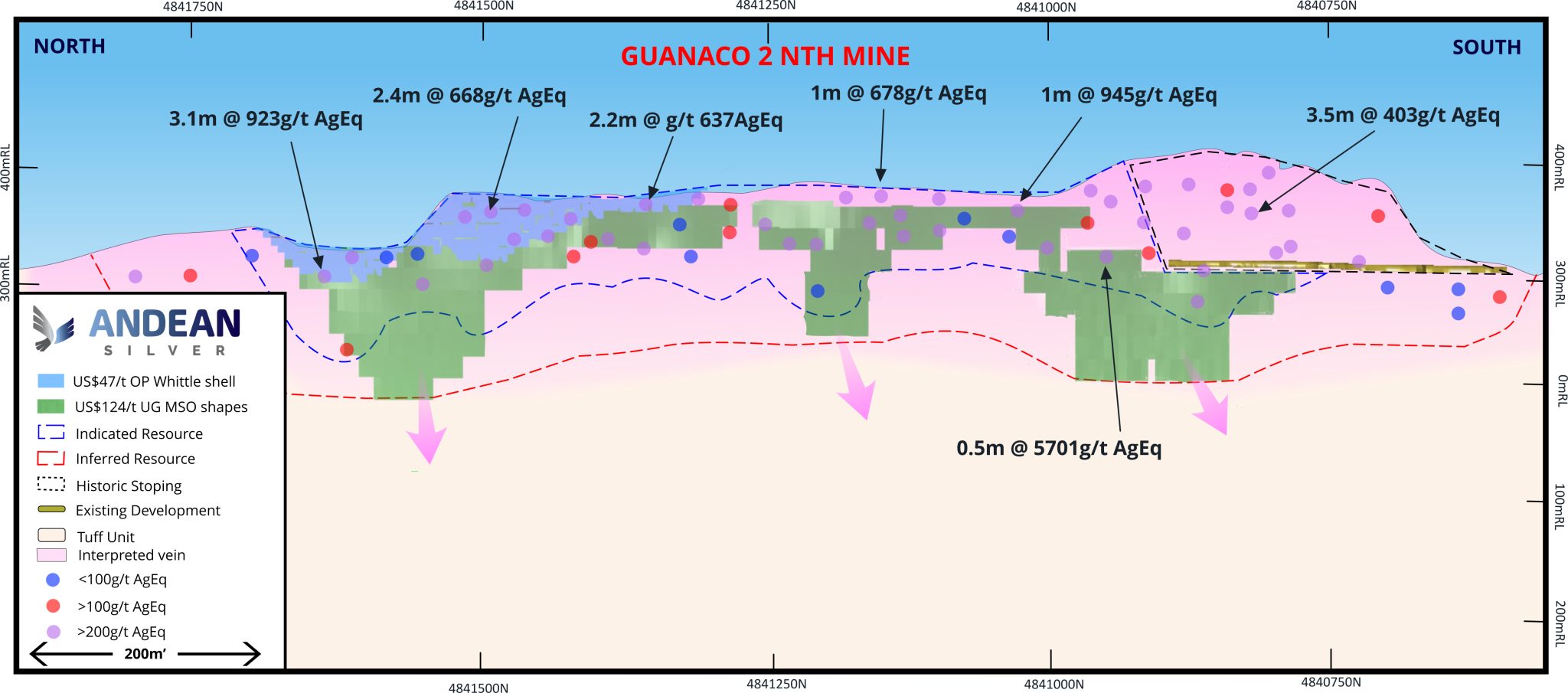

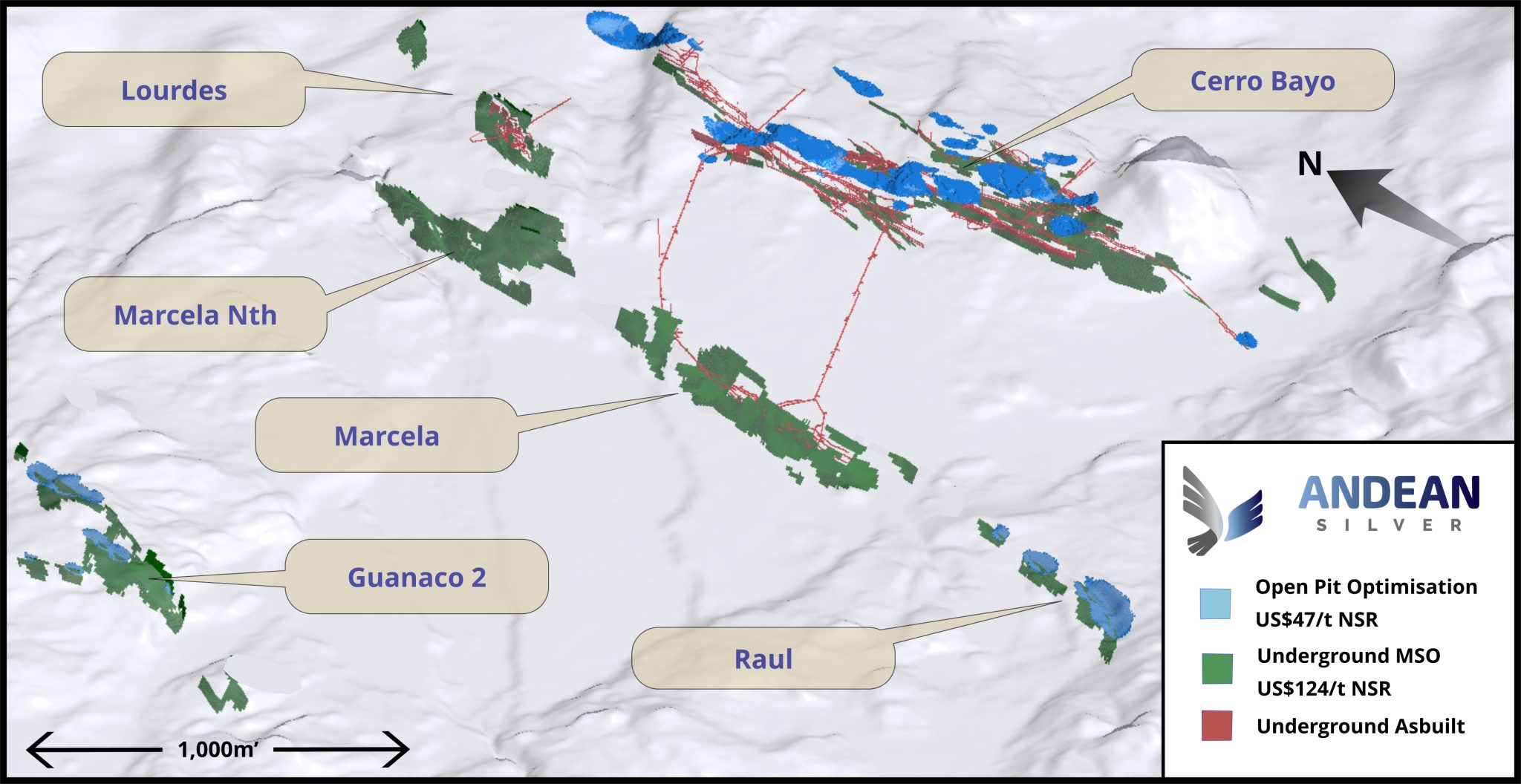

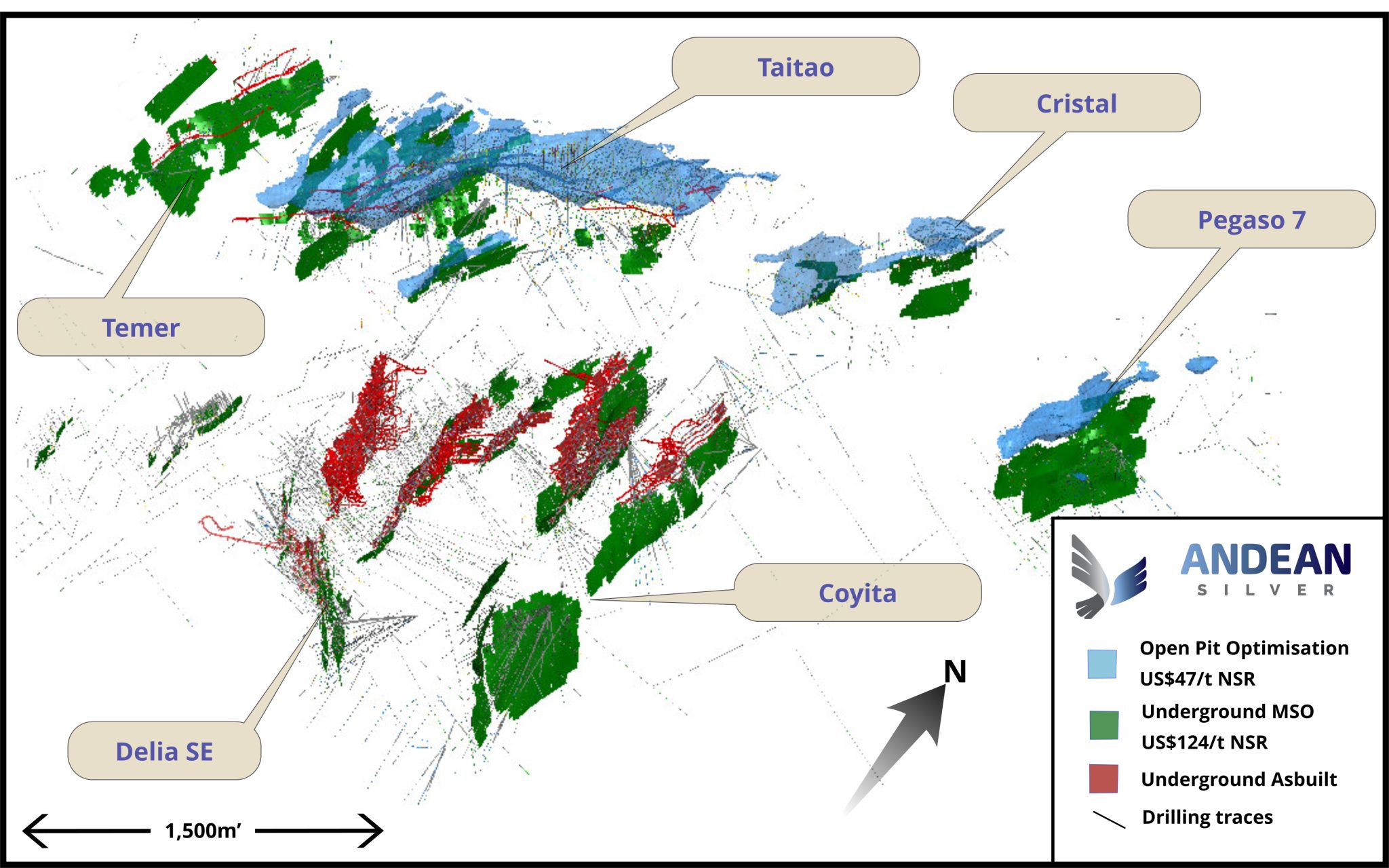

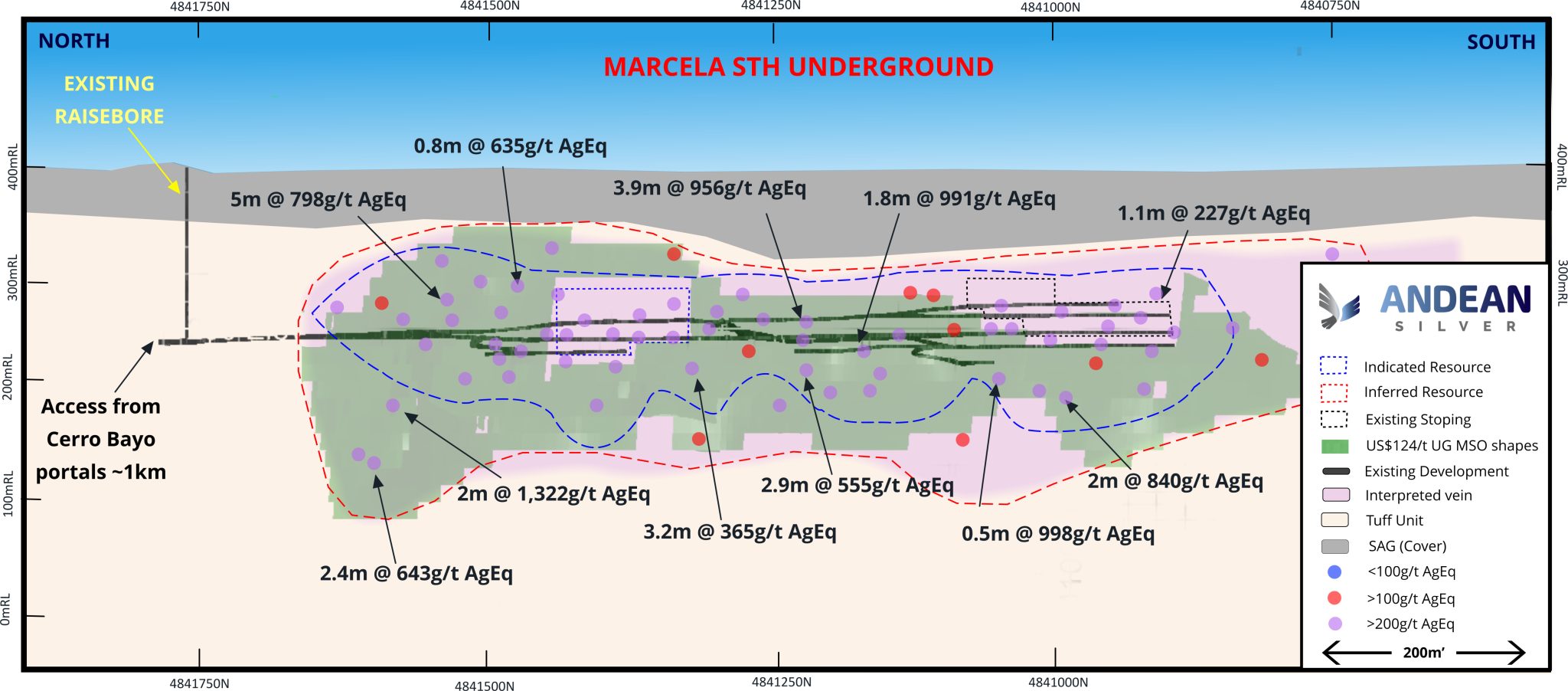

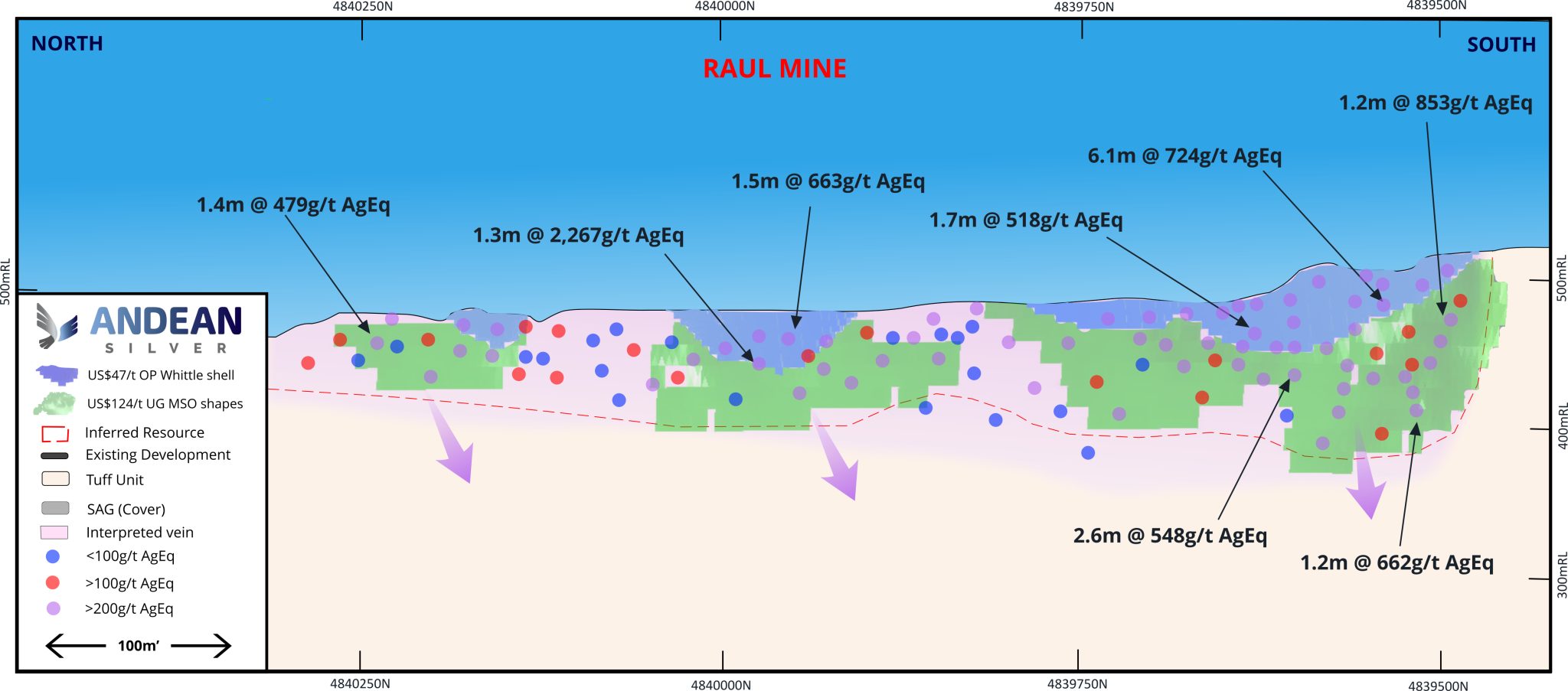

Geology

Forward Work Plans

Twelve Month Strategy and News Flow

Andean continues to effectively execute an aggressive exploration and Resource growth and definition campaign throughout its 330km2 Cerro Bayo Silver-Gold Project. During the remainder of 2026 and into 2027, the Andean team aims to advance the project from a predominantly exploration focus to a combination of exploration and restart planning. Andean’s strategy includes:

Exploration:

Restart Planning:

In addition to the current fleet of 4 drill rigs, the Company will consider increasing the number of rigs on site to support all planned 2026 and 2027 activities to achieve the Company’s strategic goals.

Table 1: News flow over the coming 12 months.

The below timetable is indicative only and is subject to change.
